Celebrating Our Milestones of Success

celebrating-our-milestones
port

Tbilisi Dry port Phase II

  • Container Yard Expansion
  • Class A covered warehouse
  • New rail line spurs
  • Fencing
  • Truck Parking
  • New Gates

2025 q2 COMPLETED

  • Paving tiles stowage
  • Office building internal works
  • Inbound CCTV installation
  • Warehouse lightings
  • Gate offices installation
  • IT infrastructure implementation
  • Sidewalk preparation
  • Internal railway spurs registration
  • Operations and inspection building construction
  • Trees replanting and cutting

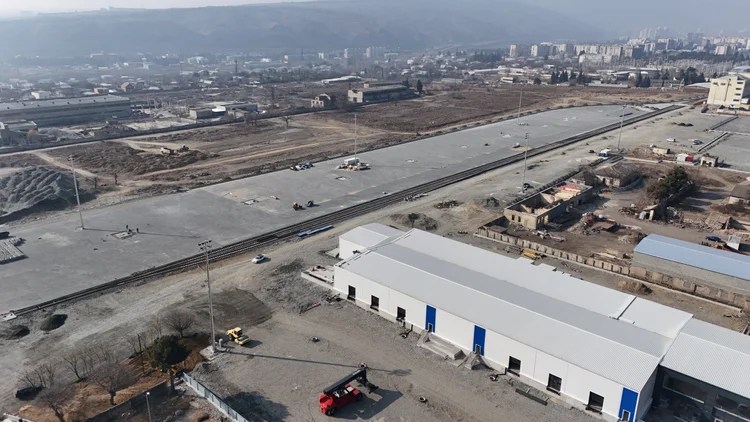

q4-2024

2024 Q4 Completed

  • Reinforced Concrete (RC) works
  • Office, B class warehouse and mechanization construction works
  • Outdoor drainage systems
  • Outdoor electrical works contract
  • Existing power cable relocation
  • Awarding and contracting MEP contractor
  • RC wall works
  • Water reservoir construction
  • Fencing
  • Outbound CCTV installation
  • Outdoor lightings

PRESENT (UNDER PROGRESS)


Reinforced Concrete (RC) works

Ballast supply and compaction

Office, B class warehouse and mechanization construction works

Outdoor drainage systems

Outdoor electrical works contract

Existing power cable relocation

Updating A Class MEP drawings preparation

Awarding and contracting MEP contractor

RC wall works

Water reservoir construction

Fencing

Trees replanting and cutting

April 2024 (COMPLETED)


Build Permit obtained

March 2024 (COMPLETED)


AD Ports Group acquires majority stake in Tbilisi Dry Port. For more information, please check it out here.

Q3 2023 (COMPLETED)


  • Urban Design Review Panel (UDRP)
  • Paving of the territory
  • Supply of territory ballast
  • Ground Excavation works
  • Purchase of Equipment
  • Mechanization building
  • Railway construction
  • Suppliers of dock levers, sectional door, outdoor lighting system have been selected

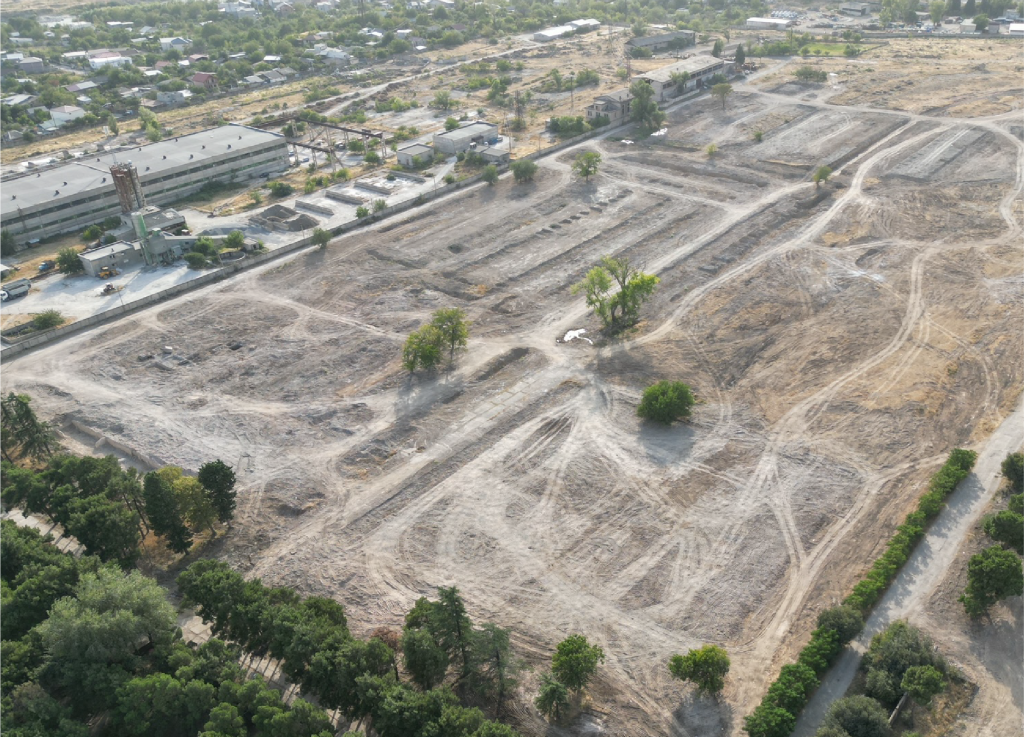

Q3-COMPLETED-2023

2022 – Q2 2023 (COMPLETED)


  • Railway link between the main station and the Dry Port premises
  • Gravelling and leveling works
